Power Guide: Building Construction Process in Nigeria (2026) β€” Stages, Timeline, Cost Breakdown, BOQ & Approval Checklist

Building construction process
Setting out with pegs and builder’s line β€” surveyor using total station
The building construction process in Nigeria looks simple on WhatsApp videosβ€”clear the land, dig foundation, raise blocks, roof, plaster, paint. But in real life, most Nigerian projects fail on the β€œinvisible parts”: weak pre-construction planning, wrong setting-out, poor drainage, unverified soil conditions, unclear contractor scope, missing approvals, and procurement delays that inflate costs mid-project. That’s why the winners (especially in Lagos, Abuja, Enugu, Port Harcourt, Ibadan) treat construction like a system: design β†’ approvals β†’ BOQ β†’ procurement β†’ quality control β†’ payment milestones β†’ handover.

In Nigeria’s environment, you’re building in the middle of:

  • Material price volatility and supply shocks

  • Rainy season disruptions (access roads, flooding, curing issues)

  • Power/water realities that affect MEP design

  • Regulatory requirements (planning permits and inspection expectations)

  • Labour variability and workmanship gaps

This pillar guide breaks down the house construction steps in Nigeria from pre-construction to handoverβ€”explaining what happens at each stage, what to inspect, how to prevent rework, and how to plan your budget using a construction BOQ in Nigeria. You’ll also get timelines, payment structure logic, and the mistakes Nigerians make that quietly double cost and time.


SUMMARY TABLE

Topic Key Insight Notes
Pre-construction Most cost overruns start before excavation BOQ + procurement plan reduce surprises
Approvals Don’t build β€œhopefully”—get permits early Lagos uses EPPPS planning permit platform
Setting-out Wrong set-out = permanent structural mistake Confirm benchmarks + diagonals
Substructure Drainage + DPC quality decides long-term durability Wet base = damp walls + repairs
Superstructure Quality control on concrete and alignment matters Avoid β€œspeed over strength”
Roofing Poor roof detailing causes recurring leaks Insulation + ventilation improve comfort
MEP Coordinate early to avoid chasing pipes in finished walls MEP clashes are expensive
Handover As-builts + defect liability protect your money Record what was actually built

What β€œConstruction Process” Means in Nigeria (Beyond Blocks & Cement)

The building construction process in Nigeria is a chain of decisions that must stay aligned:

  • Architecture & engineering: designs that are buildable and compliant

  • Real estate and approvals: land documents, planning permits, setbacks

  • Construction management: schedule, procurement, labour control

  • Quality assurance: inspections at every stage

  • Cost control: BOQ-driven purchasing, variation control, milestone payments

  • Infrastructure reality: water storage, septic/soakaway, power systems, access roads

If you miss alignment at any point, the project pays laterβ€”usually through rework, delays, and disputes.


Detailed Step-by-Step Breakdown: Stages of Building Construction in Nigeria

Step 1: Pre-Construction Planning (Brief β†’ Design β†’ Approvals β†’ BOQ)

This stage determines 70% of your final cost and timeline.

Key deliverables

  • Project brief: size, lifestyle needs, rental goal, finish level

  • Architectural drawings + structural + MEP coordination

  • Compliance check: setbacks, access, parking (where applicable)

  • Construction BOQ in Nigeria (Bill of Quantities): itemized materials + labour + preliminaries

  • Procurement plan: what to buy early (high volatility items) vs later

Approval reality (Nigeria)

  • Lagos State runs an electronic platform for planning permits (EPPPS)

  • Professional registration matters: ARCON is the regulator of architectural practice and licensure in Nigeria

Developer tip: Don’t start excavation until your approvals and BOQ are clearβ€”β€œstart now, correct later” is one of the costliest Nigerian habits.

Building Construction Process
Stages from design to foundation to roofing to finishing

Step 2: Site Setup & Setting Out (Accuracy Before Speed)

This is where many Nigerian buildings get future cracks and boundary issues.

Site setup checklist

  • Clearing, leveling, and access paths

  • Temporary services: water, site store, secure tool area

  • Benchmarks and reference points (re-check after heavy rains)

Setting-out quality controls

  • Confirm building lines and setbacks

  • Confirm diagonals (square corners)

  • Confirm levels (to avoid drainage problems later)

Nigeria-specific warning: In flood-prone areas (common in parts of Lagos and riverine zones), wrong finished floor levels lead to permanent damp and seasonal flooding complaints.

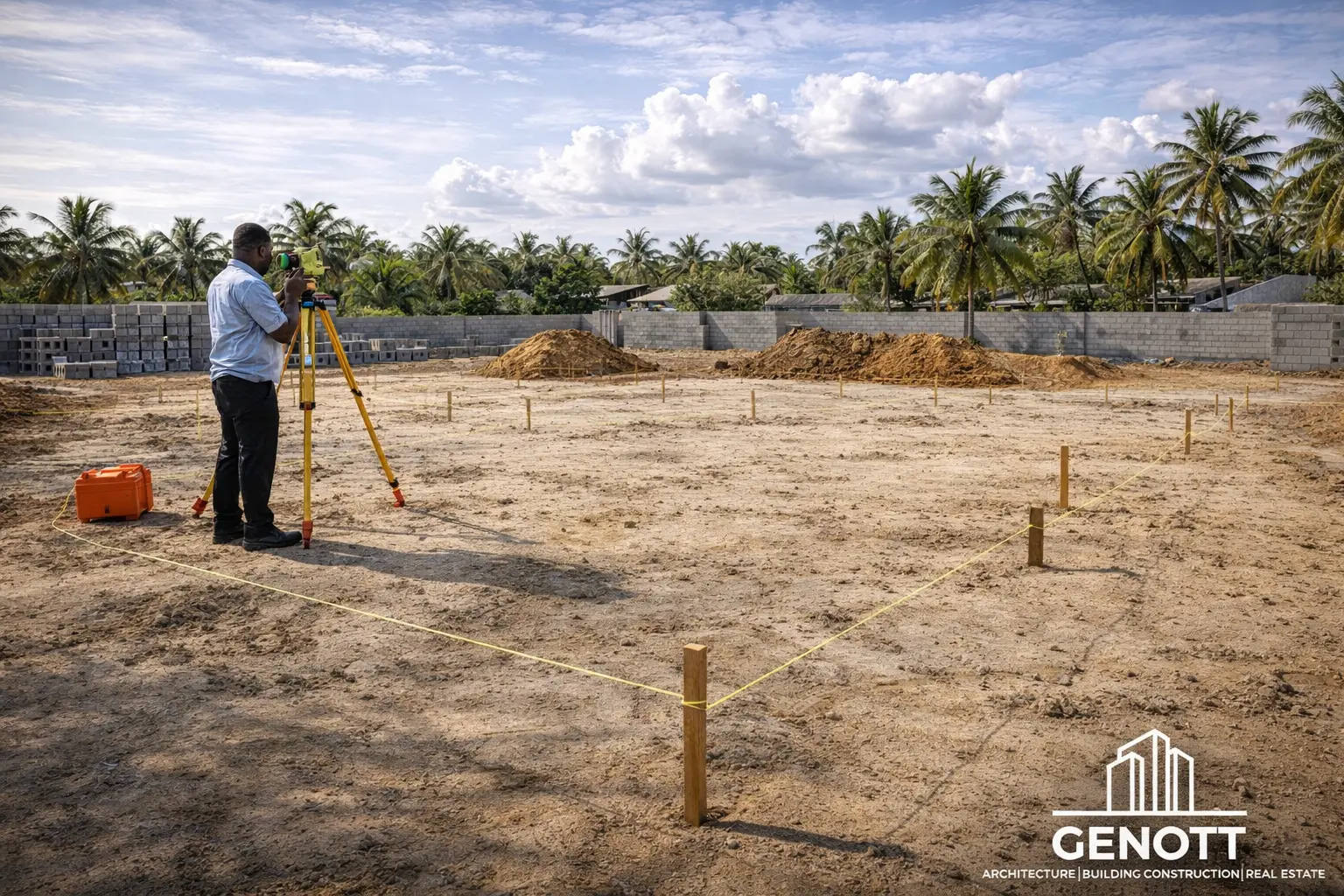

Building construction process
Setting out with pegs and builder’s line β€” surveyor using total station

Step 3: Foundation Stage (Substructure)

This is the β€œhidden stage” that determines stability.

Typical foundation workflow

  • Excavation (trenches/pads)

  • Blinding concrete (where specified)

  • Rebar placement + formwork

  • Casting footings / ground beams

  • Blockwork to DPC level

  • Damp-proof course (DPC) / damp-proof membrane (DPM) as required

  • Backfilling and compaction

  • Drainage provisions (especially where water tables are high)

Quality control

  • Concrete mix discipline and curing

  • Rebar spacing/cover

  • DPC continuity (no gaps)

Cost note: Poor compaction and drainage errors are some of the most expensive β€œinvisible mistakes” because repairs happen after finishes are already paid for.

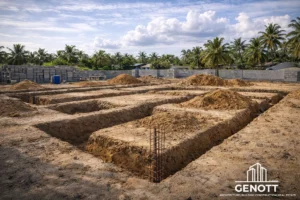

Building Construction Process
Building Construction Process (Foundation trenching)
Building Construction Process.

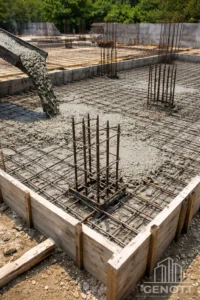

Reinforcement rebar grid and concrete casting

Step 4: Superstructure Stage (From Ground Floor to Lintels/Slab)

Now the structure risesβ€”this is where speed temptation destroys quality.

Superstructure activities

  • Columns and beams (RC frame) or load-bearing walls (where used)

  • Blockwork alignment and verticality checks

  • Lintels and ring beams

  • Slab casting (for duplexes and multi-level structures)

  • Staircase construction (if duplex)

Inspection mindset

  • Keep records of reinforcement and concrete pours

  • Confirm openings sizes (doors/windows) before casting lintels

  • Don’t allow β€œadjust on site” without designer sign-off

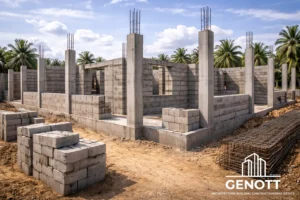

    Building Construction Process
    Super Structure

Step 5: Roofing Stage (Trusses, Sheets, Gutters, Insulation, Ceilings)

Roofing is a major cost driver and a major leak risk.

Options

  • Timber truss (common)

  • Steel truss (often better for durability, cost depends on market)

Roof details that reduce future costs

  • Proper valley gutters and flashing

  • Correct slope and sheet overlap

  • Fascia and gutter detailing (rain management)

  • Attic/roof ventilation + insulation strategy (comfort + energy savings)

Nigeria reality: A roof that leaks once usually leaks again unless the detailing is corrected, not β€œpatched.”


Step 6: MEP Installation (Plumbing, Electrical, AC, Water, Septic)

MEP is where houses become functionalβ€”and where rework becomes expensive.

MEP includes

  • Plumbing: supply lines, drainage, venting

  • Electrical: conduits, DB placement, earthing

  • AC provisions: sleeves, drainage routes

  • Water storage + pumping strategy

  • Septic/soakaway or treatment system (depending on context)

Coordination rule: MEP must be planned early. Chasing pipes through cured concrete or finished walls is one of the fastest ways to blow budgets.


Step 7: Finishes Stage (Where Budgets Often Die)

Finishes are where Nigerian projects swing from β€œmanageable” to β€œuncontrolled.”

Finishes include

  • Plastering and screeding

  • Tiling and wall finishes

  • Doors/windows

  • Painting

  • Sanitary fittings, kitchen works

  • External works: paving, fences, gates

Cost control tactic: Lock a finishes schedule early (tile sizes, door counts, sanitary brands). If not, β€œsmall upgrades” multiply into millions.


Step 8: Quality Control & Supervision (Continuous, Not Final-Day)

Quality checks should be stage-based, not emotional.

Quality framework

  • Stage inspections (foundation, slab, roof, MEP rough-in, finishes)

  • Material checks (cement storage, steel quality, sand quality)

  • Snagging lists before handover

  • Compliance checks aligned with regulatory expectations (planning/building controls and inspections)
    Nigeria’s National Building Code exists as a reference framework for building standards and safety expectations.


Step 9: Contracting & Payment Structure (Milestones, Retention, Variations)

Most disputes come from unclear scope and payment logic.

Best practice payment structure

  • Mobilization (small, controlled)

  • Substructure milestone

  • Superstructure milestone

  • Roofing milestone

  • MEP rough-in milestone

  • Finishes milestone

  • Practical completion + retention

Variation control

  • Written variation orders only

  • Costed before execution

  • Approved by client (and ideally designer/PM)


Step 10: Handover & Post-Construction

A professional handover protects value.

Handover package

  • As-built drawings (what was actually built)

  • Test certificates (where applicable)

  • Maintenance plan (roof, plumbing, pumps, paint cycles)

  • Defects liability period agreement


Cost Analysis & Investment Insights: Construction Cost Breakdown in Nigeria

Instead of guessing, split costs like a developer:

Cost Bucket What It Covers Why It Matters
Preliminaries site setup, security, temporary works Often ignored but unavoidable
Substructure excavation, concrete, rebar, DPC Hidden but foundational
Superstructure blockwork, beams/columns, slab Controls structural quality
Roofing truss, sheets, gutters, ceilings A major leak-risk area
MEP plumbing, electrical, water systems High rework risk if delayed
Finishes tiles, doors, paint, fittings Biggest budget swing
External works fence, paving, drainage, gate Often forgotten until late

Investment insight: If you’re building for rental income (Lagos/Abuja student hubs, Enugu family rentals), cost control and timeline control matter as much as design beautyβ€”because delays destroy your payback period.


Comparisons or Alternatives: Bungalow vs Duplex Construction Process Differences

Element Bungalow Duplex
Structural complexity Often simpler Slab + stairs add complexity
Timeline Often shorter Often longer
MEP routing Mostly single level Vertical stacks require more planning
Roofing Larger roof footprint Smaller roof footprint (often)
Best for Elder-friendly living Privacy zoning + tight plots

Use this comparison to adjust your construction timeline for a house in Nigeria and your BOQ.


Common Mistakes Nigerians Make During the Construction Process

  1. Starting without approvals and clear drawings (then redesigning on site)

  2. No BOQβ€”buying materials emotionally and inconsistently

  3. Poor setting-out (boundary problems, wrong room sizes)

  4. Weak drainage planning (especially during rainy season)

  5. Paying contractors without milestone verification

  6. Allowing uncontrolled β€œvariations” without written costs

  7. Installing MEP late (leading to cutting finished work)

  8. No supervision (quality becomes luck)


Expert Recommendations

  1. Treat construction as a project system
    Design + approvals + BOQ + schedule + procurement + QA must align.

  2. Use BOQ-led procurement
    A BOQ is how professionals prevent market volatility from turning into chaos.

  3. Build climate-smart, Nigeria-smart
    Plan drainage aggressively, elevate where needed, and detail roofs properly.

  4. Use milestone payments and retention
    Pay for verified progress, not promises.

  5. Professional accountability
    Work with registered professionalsβ€”ARCON provides the formal licensure framework for architects in Nigeria.


  • More adoption of portal-based approvals and documentation workflows in major states (e.g., Lagos EPPPS).

  • Stronger emphasis on quality control as building failures remain a public concern (driving demand for compliance and supervision)

  • Increased use of energy-smart detailing (roof insulation, shading, ventilation planning) to reduce running costs

  • More structured project management culture among private developers (especially for estates and mixed-use projects)


FAQs

1) What are the main stages of building construction in Nigeria?
Pre-construction planning, site setup/setting-out, foundation, superstructure, roofing, MEP, finishes, inspections, and handover.

2) How long is the construction timeline for a house in Nigeria?
It depends on size, design complexity, approvals, and funding flow. Bungalows often finish faster than duplexes, but procurement delays can extend both.

3) Why is a BOQ important in Nigeria?
A BOQ helps you control cost, plan procurement, and reduce wasteβ€”especially when material prices fluctuate.

4) What is β€œsetting out” and why is it critical?
Setting-out transfers the drawing to the ground. Wrong set-out causes permanent room size errors, misalignment, and approval complications.

5) Do I need building approvals before construction?
Yes. Requirements vary by state, but Lagos uses an electronic planning permit platform (EPPPS) for processing applications.

6) When should plumbing and electrical work start?
Earlyβ€”MEP should be coordinated during design and installed during the right construction stages to avoid cutting finished walls and slabs.

7) How do I choose a contractor in Nigeria?
Use written scope, BOQ, milestone payments, references, and supervision structure. Avoid β€œopen-ended” pricing.

8) How do I verify an architect is properly recognized in Nigeria?
ARCON is the statutory body that regulates architectural practice and licensure.


CONCLUSION

The building construction process in Nigeria becomes affordable and predictable when you treat it like a professional workflowβ€”not a trial-and-error journey. The most successful projects lock the brief, drawings, approvals, and BOQ early; execute setting-out accurately; build strong substructure with proper drainage and DPC; manage superstructure and roofing with disciplined quality control; coordinate MEP before finishes; and protect budgets using milestone payments and variation control.

Whether you’re building in Lagos, Abuja, Enugu, Ibadan, or Port Harcourt, the same truth applies: construction is either managedβ€”or it becomes a cost leak.


For professional support, GENOTT LTD provides expert guidance in architectural design, BOQ preparation, project planning, site supervision, approvals documentation, construction delivery, and cost-control frameworksβ€”helping you complete projects with quality, compliance, and budget discipline.
